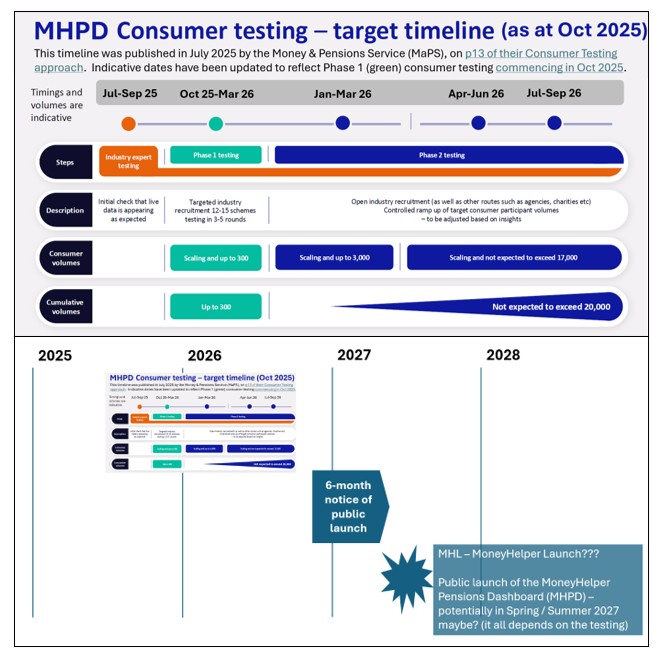

19 November 2026 – PDP Town Hall event
Speaking at the third PDP Town Hall event, Minister for Pensions Torsten Bell MP announces (and a PDP press release confirms) that MHPD is expected to be publicly available in the summer of 2027.
MaPS PDP also publishes a report on the initial outcomes of extensive social research, conducted by Ipsos, into consumers’ experience of using MHPD (which I highlight in a LinkedIn post).

4 November 2026 – PPI UK Pensions Framework 2026
A Pensions Policy Institute (PPI) press release announces the publication of the UK Pensions Framework 2026 which, on page 41, says “Fragmented pension saving creates the greatest challenges for workers already at risk of inadequate pension outcomes … [and] The forthcoming MoneyHelper Pensions Dashboard is expected to reduce one of the key challenges associated with fragmentation by enabling savers to find and view information on all their pensions in one place”. I promote this “greatest challenge” statement in a LinkedIn post.
3 November 2026 – Guided Retirement consultation
I lament, in a LinkedIn post, how dashboard is only mentioned five times in the over 35,000 words of the DWP consultation on Guided Retirement (GR), summarised in a DWP press release.
Also relevant to dashboard, because it shows provider-calculated income projections, are FRC’s two publications: an AS TM 1 Post Implementation Review and a Discussion Paper on Additional Ilustrations.
2 November 2026 – Lead Delivery Manager
MaPS is recruiting for lots of different roles to support the ongoing operation of its Pensions Dashboard Service (PDS). One is a Lead Delivery Manager, a leadership role supporting the Service Owner focused on bringing together service operations, policy, strategy, suppliers and technical teams to ensure the service meets user needs, is safe, resilient and well run, and that it keeps improving over time.
I am very surprised the job description does not mention the pensions industry as all the post-launch iteration of continental dashboards has been a collaborative effort with industry.
24 October 2026 – Coverage on Radio 4 and in Caithness
Just to illustrate dashboard is a truly national initiative, Caithness.Org based in the far north of Scotland (and where my lovely wife Heather was born, in Thurso) features the topic and posts the article on Facebook.
Dashboard also features on this weekend’s edition of Money Box on BBC Radio 4, picked up by The Express the next day to coincide with National Pension Tracing Day. I highlight the coverage in a LinkedIn post.

20 October 2026 – Resolving Possible Matches
A PASA press release announces the publication of new guidance for scheme administrators and pension providers on good practice for Resolving Possible Matches (RPM).

14 October 2026 – Pensions UK Conference and PDP Dashboards Hub
A PDP LinkedIn post and news announcement summarise MaPS CEO Oliver Morley’s address on the pensions dashboard to the Pensions UK Annual Conference 2026 in Liverpool. The post also promotes PDP’s new Dashboards Hub, containing a suite of information about the MHPD.

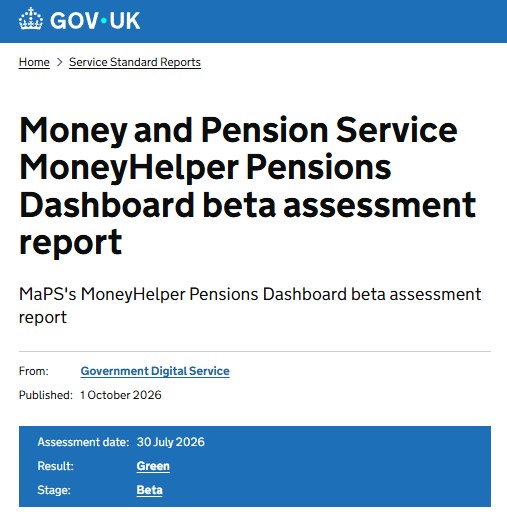

1 October 2026 – MHPD Beta SSA Report
The Government Digital Service (GDS) publishes the report from the Beta Service Standard Assessment (SSA) of the MHPD carried out in July.

17 September 2026 – MHPD testing blog
A PDP blog article announces a simplified process from 1 September to sign-up as an MHPD tester, so there are now two routes:
- invite your audience (instructions on PDP site)
- sign-up directly as a consumer tester (instructions on MoneyHelper site – also currently the very first Hot topic on the MoneyHelper homepage)

1 September 2026 – PASA post use behaviour toolkit
A PASA press release announce new Post Use Behaviour toolkit content encouraging schemes to think about monitoring how member behaviour changes once dashboards are available, and whether any emerging trends require further action.

31 August 2026 – Penultimate connection date
I mark the DWP’s penultimate staged “Connect by” date with my second last “Thundashboard” countdown LinkedIn post – just for fun!

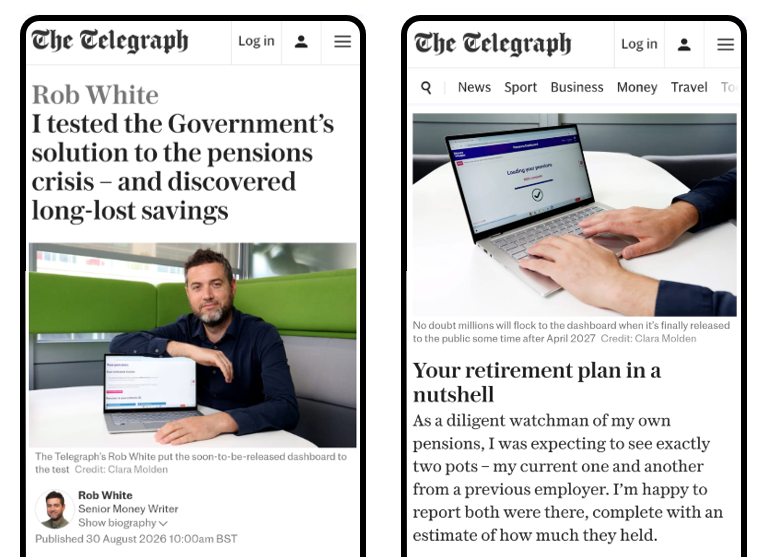

30 August 2026 – Telegraph review
The Telegraph’s Senior Money Writer Rob White writes about his experience using the MHPD for the first time, which I highlight in a LinkedIn post.

27 August 2026 – PDP Delivery timeline
PDP publishes a delivery timeline, which I highlight in a LinkedIn post, in particular PDP’s upcoming transition into business as usual and iteration.
20 August 2026 – Beta SSA passed
MaPS announces that MHPD has passed its beta Service Standard assessment (SSA), which I explain in a LinkedIn post.

19 August 2026 – Ongoing connection blog
MaPS publishes a blog article summarising what data providers must do to maintain their connection to the pensions dashboards ecosystem.

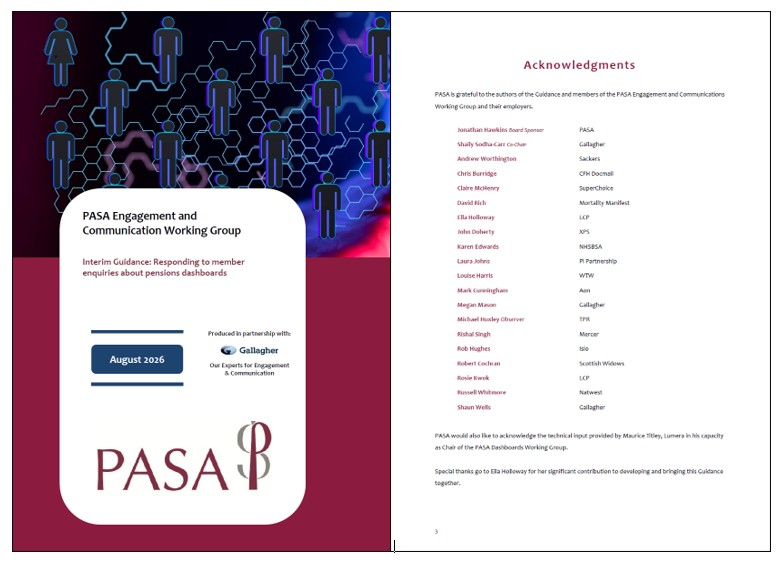

10 August 2026 – PASA interim guidance
In a press release, PASA announces publication of interim guidance on how administrators and providers should respond to member enquiries about dashboards (prior to full public availability on the MHPD, currently expected to be in 2027/28).

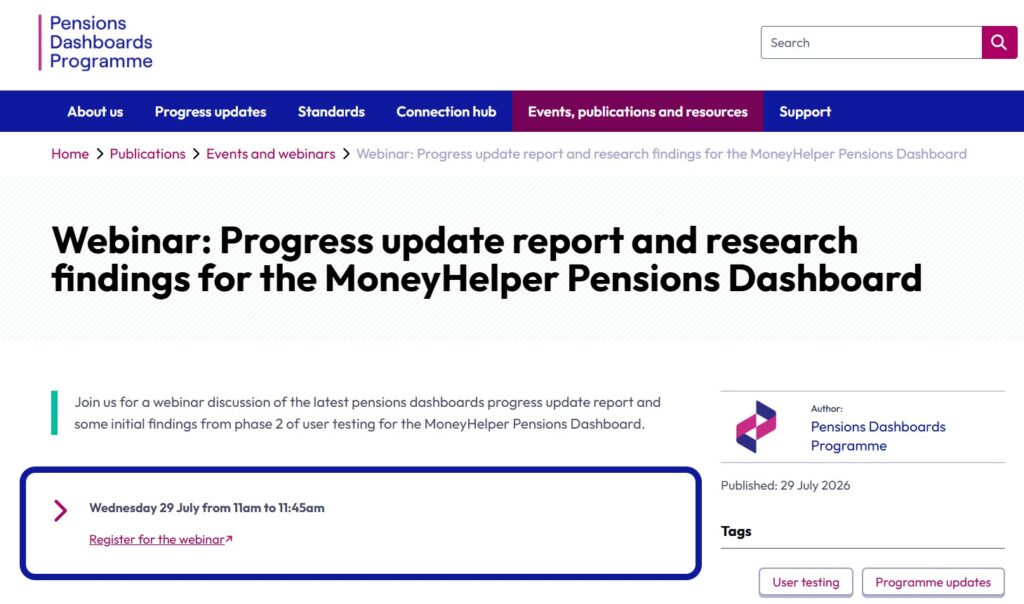

29 July 2026 – PDP Webinar
PDP hosts a webinar on its recently published PUR#13 with an update on the Phase 2 live consumer testing of the MHPD.

21 July 2026 – BAU transition lead closing date
I highlight in a LinkedIn post that applications are closing for a MaPS Lead Delivery Manager to “support the orderly transition of PDP into BAU at MaPS”.

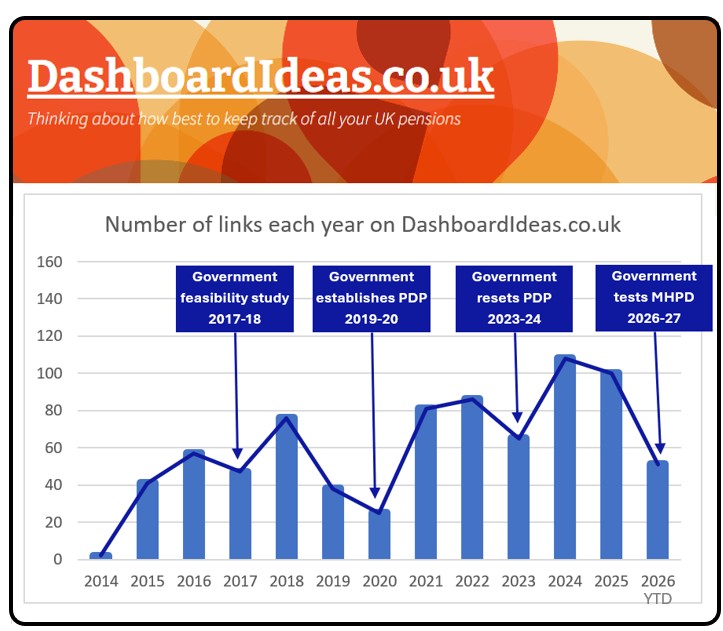

17 July 2026 – New PM and Blog’s 12th birthday
I post on LinkedIn to mark the dashboard initiative’s 7th Prime Minister and the 12th anniversary of this blog.

13 July 2026 – DWP roadmap package and NISTA Annual Report
A DWP press release announces the publication of an extensive package of materials, all built around an updated workplace pensions roadmap (which I comment on in a LinkedIn post, with a separate LinkedIn post praising the two DWP qualitative research reports also published). Dashboard hardly gets a mention.
Meanwhile, NISTA publishes its Annual Report 2025/26 with the “Delivery Confidence Assessment” of PDP remaining Amber, which I comment on in a Linked post.

8 July 2026 – TPR webinar, PUR13 and Media demo
Three things today:
- The Pensions Regulator (TPR) hosts a summer dashboards webinar

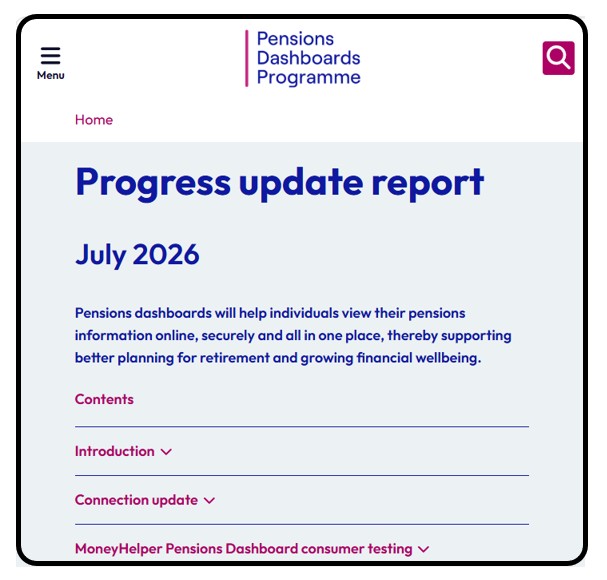

- PDP publishes its 13th six-monthly Progress Update Report, and
- Pensions Minister Torsten Bell and MaPS CEO Oliver Morley demo the MHPD to representatives from the media, securing widespread coverage, which I highlight in a LinkedIn Post.
6 July 2026 – FCA AI Review

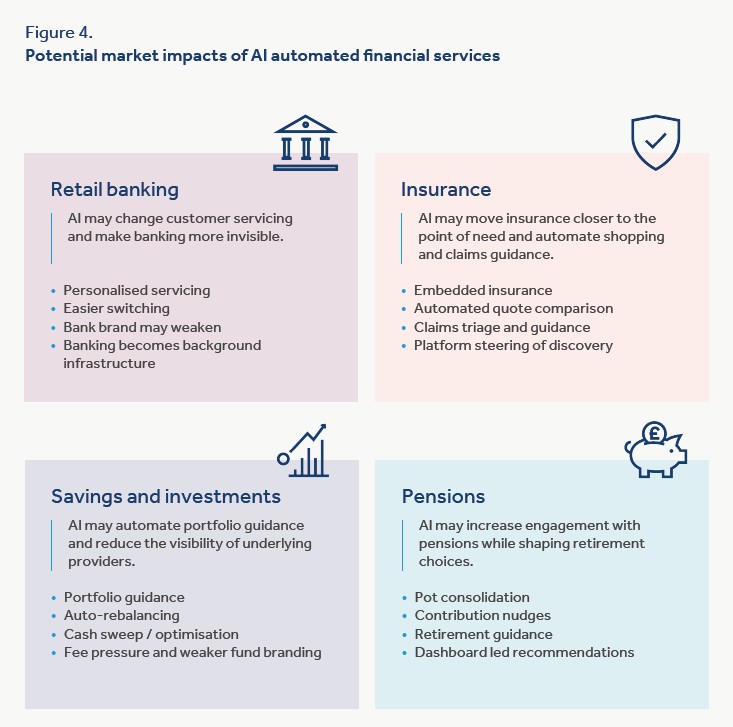

The FCA publishes ‘The Mills Review’ looking at the potential impacts of artificial intelligence (AI) on financial services, which I highlight in a Linked Post.

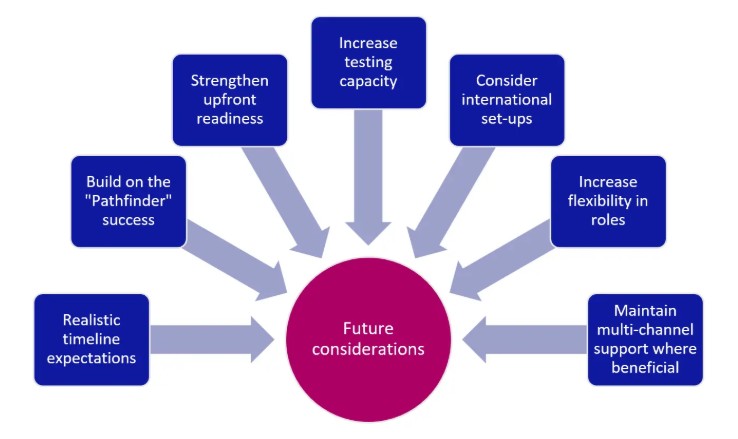

2 July 2026 – Connection evaluation
A PDP blog article and report set out an evaluation of how well the connection of data providers has gone, with a suite of lessons for the future connection model.
30 June 2026 – 4 months left & M&G Health Checks
Two updates today, which I highlighted on LinkedIn:
- Only four “Connect by” dates left in the DWP’s staging timetable for scheme connections, and

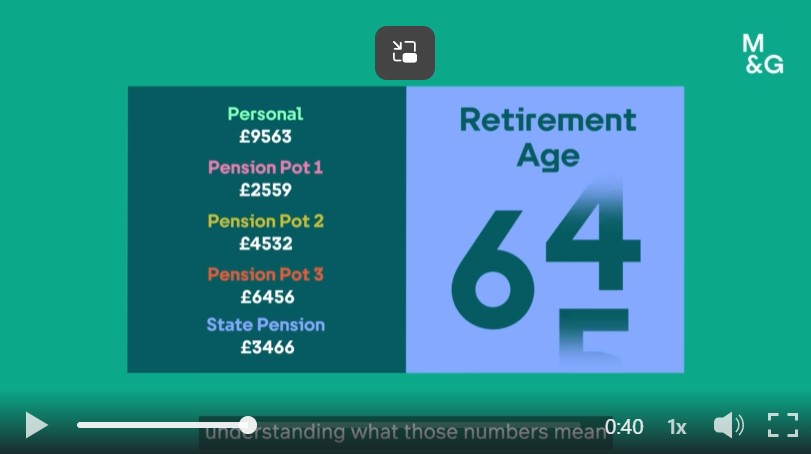

- A call by M&G for Pension Health Checks for consumers, delivered alongside the MHPD.

19 June 2026 – PDP Reporting Standards

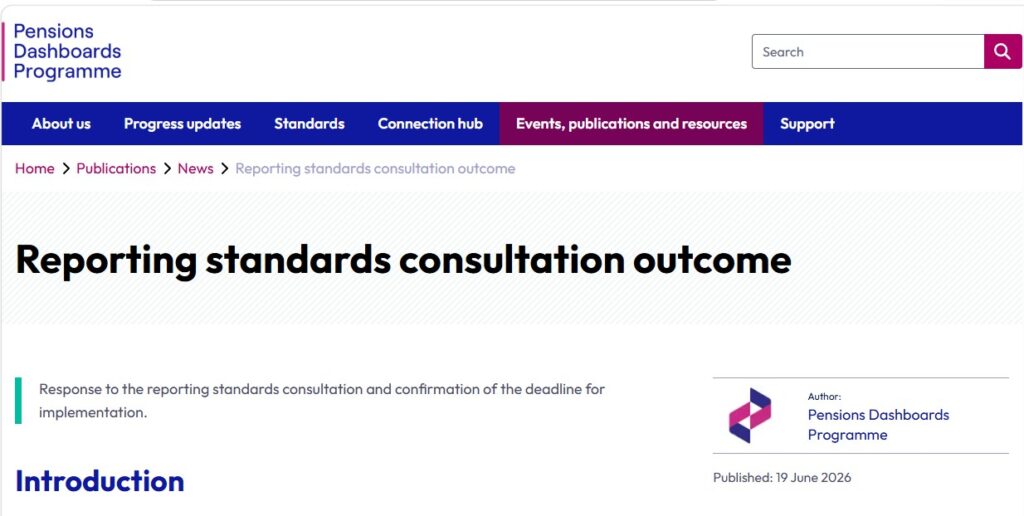

PDP publishes the outcome of its consultation on updated reporting standards, including a revised mandatory implementation deadline of 1 March 2027 for daily reporting via API in accordance with the Version 2.2 reporting standards.

18 June 2026 – PASA Guidance and MM feature
A PASA press release (and a supporting webinar) announces the publication of 30-page Dashboards Guidance on Ongoing Compliance Monitorting and much shorter Toolkit Content on Survivor Benefits.
Meanwhile an extensive Money Marketing feature asks “Are we finally ready for the pensions dashboard?”

8 June 2026 – Future Director role
Applications close for the new Director role at MaPS, responsible for the future operation and continual enhancement of dashboards for years into the future. As I say in my LinkedIn post about it, I think it’s the most important job ever in UK pensions.

4 June 2026 – PSD working group

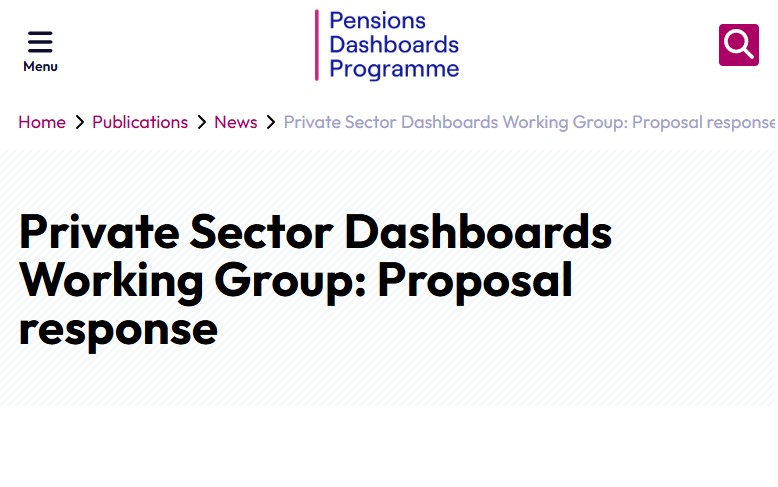

PDP publishes an update giving firms 2 weeks to decide if they wish to participate in a new working group for potential operators of Private Sector Dashboards (PSDs). PDP acknowledge that firms joining the group do so “in the very clear context of timeline uncertainty”.

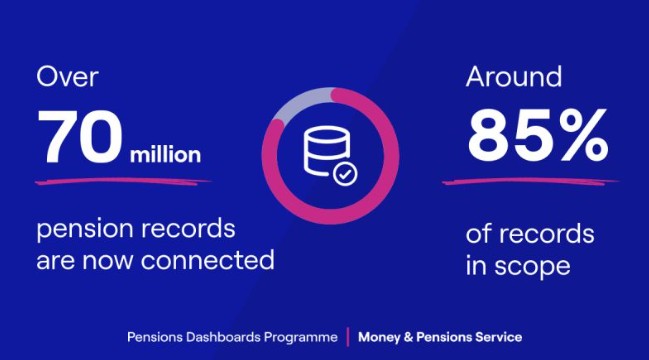

2 June 2026 – 100m+ records connected
A PDP LinkedIn post announces that over 70 million pension records are now connected to the dashboards ecosystem, plus tens of millions of State Pension records, making over 100 million connected records in total.

22 May 2026 – Contrasting nega/positivity
With public availability of the MHPD seeming ever more possible at some point during 2027, more and more content is published mentioning, or explicitly focused on, dashboard. But often with different stances.
In a LinkedIn post, I contrast a comment on Brightwell’s podcast that “we’ve been talking about dashboard [for a long time]” with a Salesforce blog predicting an “imminent” and “sustained, high-volume influx of member contact” generated by dashboard.
As I explain in the post, I think I’m somewhere in the middle on the negativity / positivity spectrum.

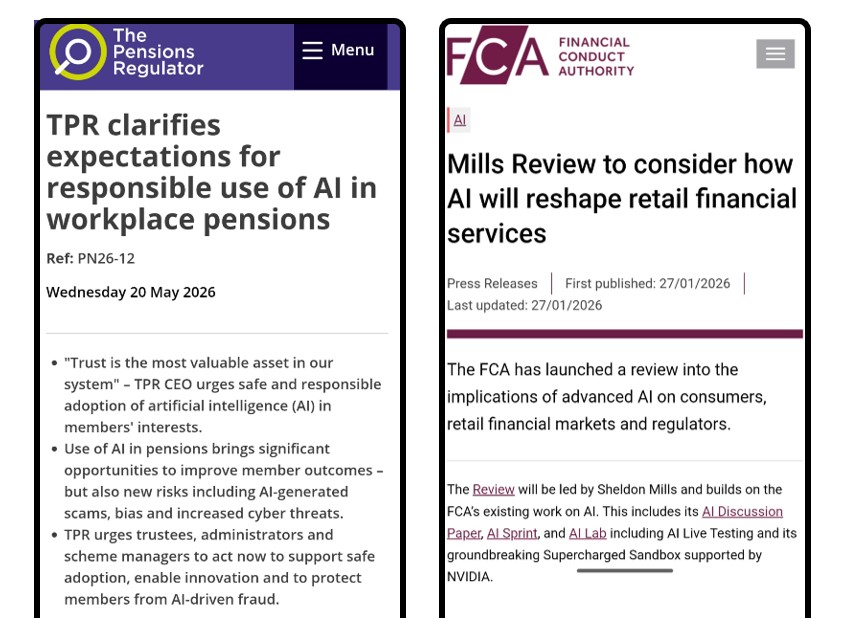

20 May 2026 – TPR AI plan
A TPR press release announces the publication of TPR’s AI plan. My popular LinkedIn post on the topic suggests we need to be thinking about this from a consumer, as opposed to just from a scheme, perspective – several Commenters agree.

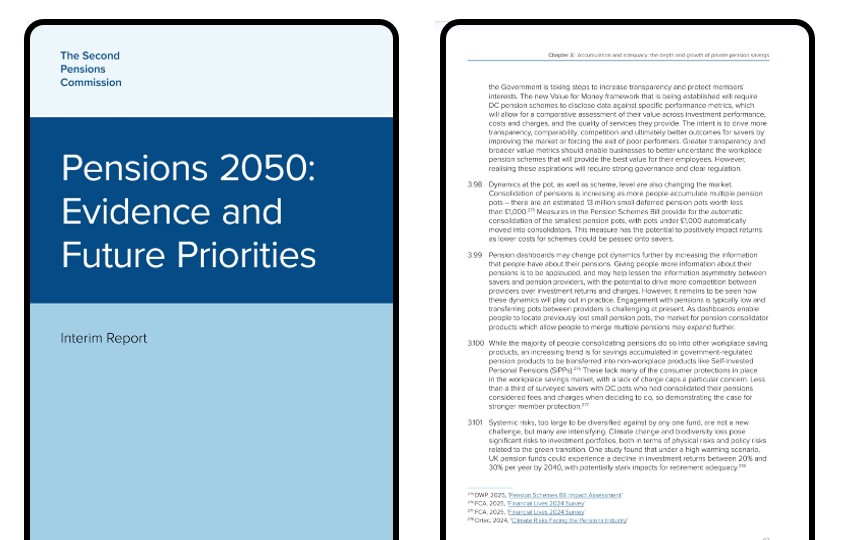

19 May 2026 – Second PC Interim Report
The Second Pensions Commission publishes its Interim Report – Pensions 2050: Evidence and Future Priorities. I express disappointment in a LinkedIn post promoting it, flagging that dashboards only get one mention.
Separately, a MaPS PDP blog article explains how the MHPD complements existing MaPS support, and my Comment on PDP’s LinkedIn post says “Don’t forget about industry”.

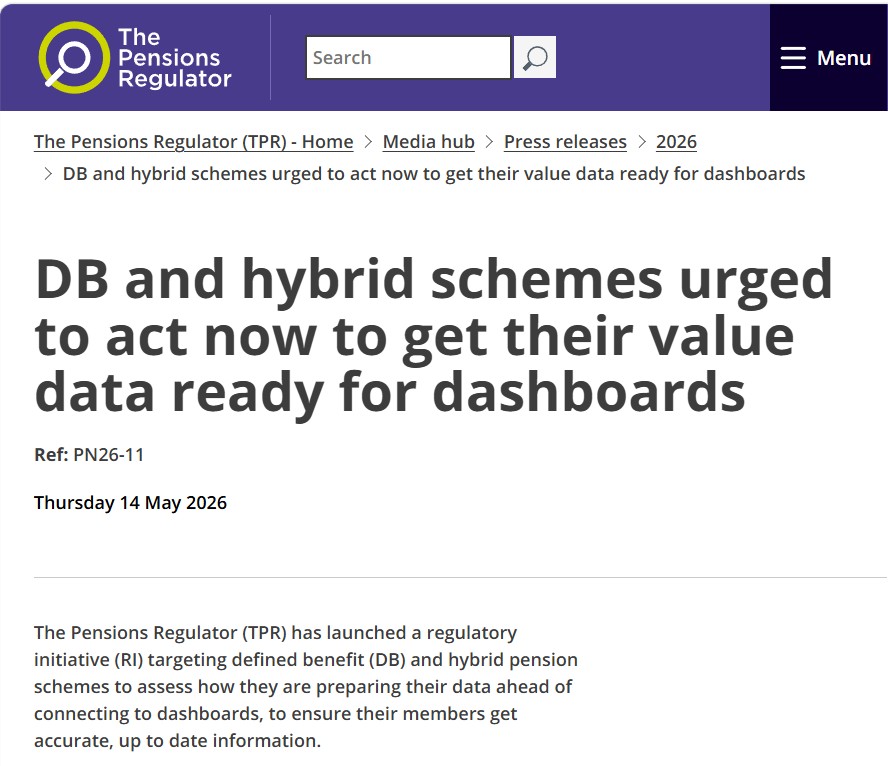

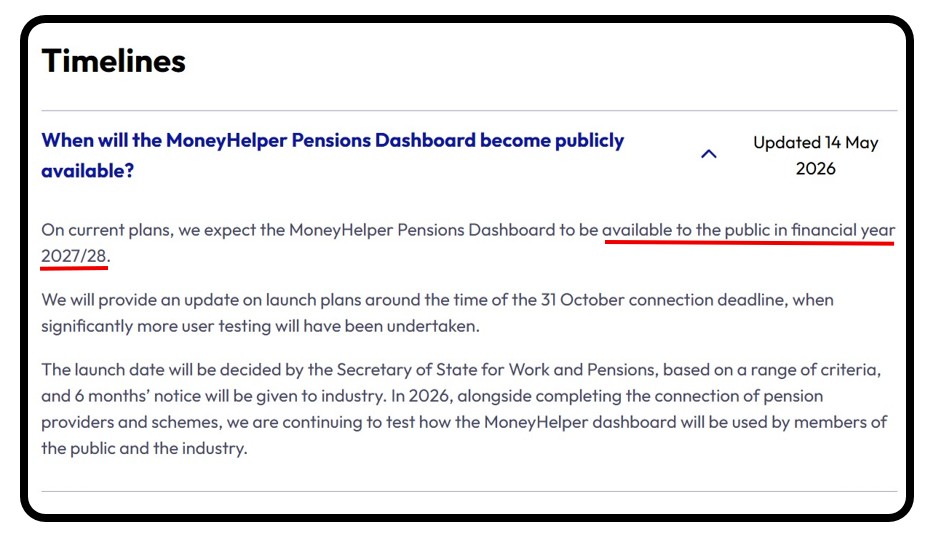

14 May 2026 – TPR RI and MHPD launch window
A press release from The Pensions Regulator announces a new Regulatory Initiative (RI) to investigate the data readiness for dashboards of 240 defined benefit / hybrid schemes, saying “Insights from this work will help inform discussions on the timing of the MHPD launch”.
And on that topic, MaPS updates one of the Answers on its Q&A from PDP’s recent webinar, saying current plans aim for the MHPD to be publicly available some time between 1 April 2027 and 31 March 2028, which is such big news that I post about it on LinkedIn.

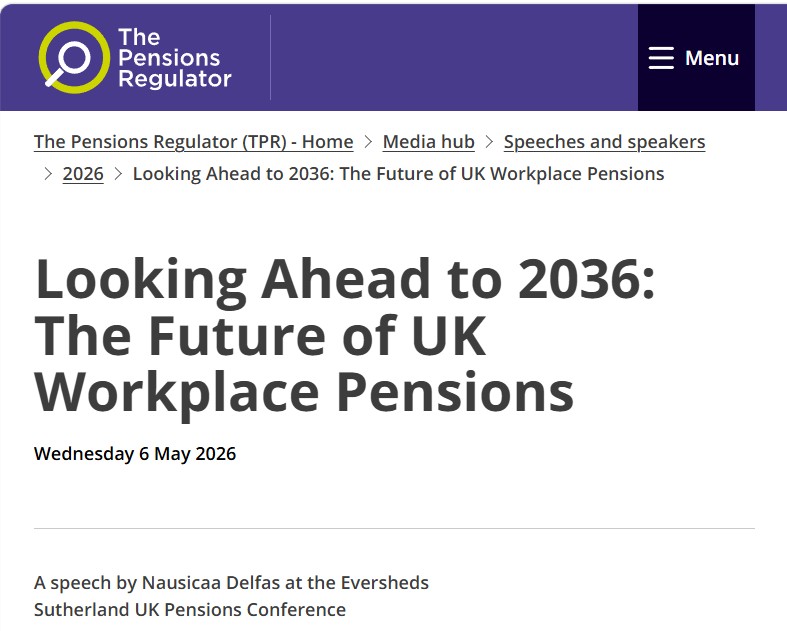

6 May 2026 – TPR CEO speech
In a speech looking ahead 10 years, TPR Chief Executive Nausicaa Delfas says that in 2036 there will be “greater transparency through dashboards … and trust … enabling members to check key metrics about their pensions”.

30 April 2026 – PDP press release and blog
PDP publishes a press release and blog article to mark only 6 months left until the final data connection deadline of 31 October 2026. Meanwhile, in a LinkedIn post, I repeat last year’s words of Paul Lewis, presenter of BBC Radio 4 Money Box: “no one’s interested in that”.
23 April 2026 – TPR package
The Pensions Regulator (TPR) publishes a package of materials relating to schemes’ dashboards compliance:
- a market oversight report on the data preparedness of large schemes
- updated guidance for schemes on their connection to the dashboards ecosystem, including
- before and after connection checklists, all summed up in
- a blog article by TPR’s Pensions Dashboards Business Lead Lucy Stone.
I promote the publication in a LinkedIn post.

22 April 2026 – PMI dashboards guide
The Pensions Management Institute (PMI) publishes a Dashboards Industry Guide 2026, surprisingly without a single screenshot of a dashboard in it.

21 April 2026 – MHPD testing results webinar
MaPS hosts a webinar sharing the findings from Phase 1 of the live consumer testing of the MHPD, and I post about it on LinkedIn afterwards.

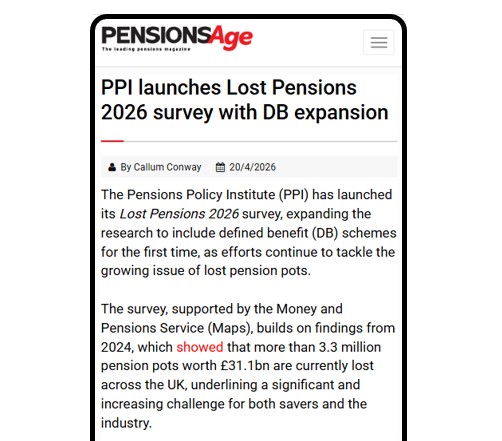

20 April 2026 – PPI lost pensions survey 2026
The Pensions Policy Institute (PPI) launches its two-yearly survey on the number of pensions where the customer or member is uncontactable (PPI calls these “lost pensions”). This time, the survey is being expanded from DC-only to include DB pensions.
I ask LinkedIn to guess the scale of the unclaimed DB pension problem.

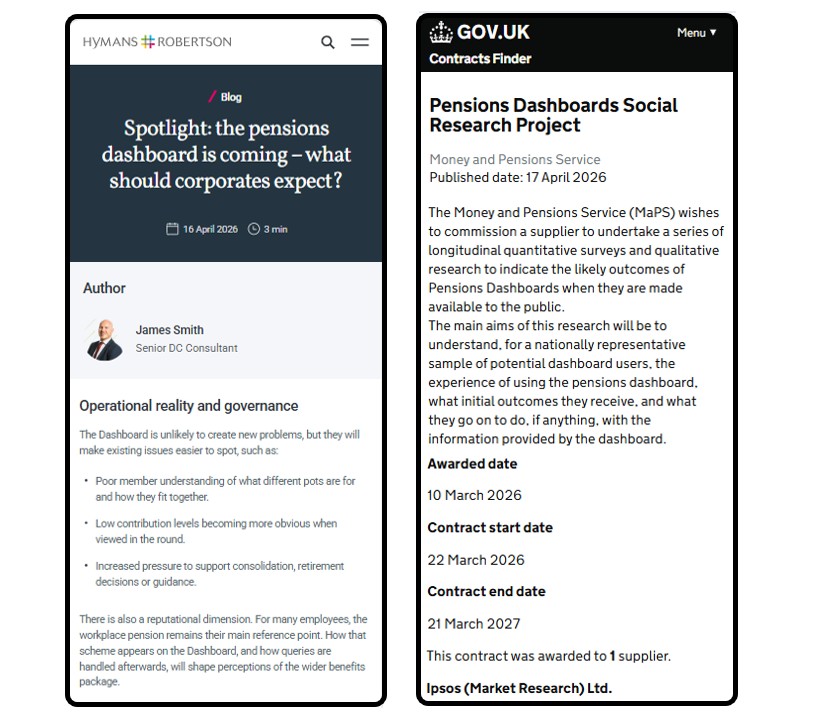

16/17 April 2026 – Hymans blog and Ipsos contract
Hymans Robertson’s James Smith publishes a ‘Spotlight’ article on the potential impacts of the MHPD on employers, including an estimate that it could be publicly available in 2026.
However, MaPS publishes a contract award notice showing that Ipsos has been awarded a contract, running through to March 2027, to research how consumers react to using the MHPD.
In light of this, I publish a LinkedIn post explaining my prediction that the MHPD might be publicly available at some point during H2 2027.

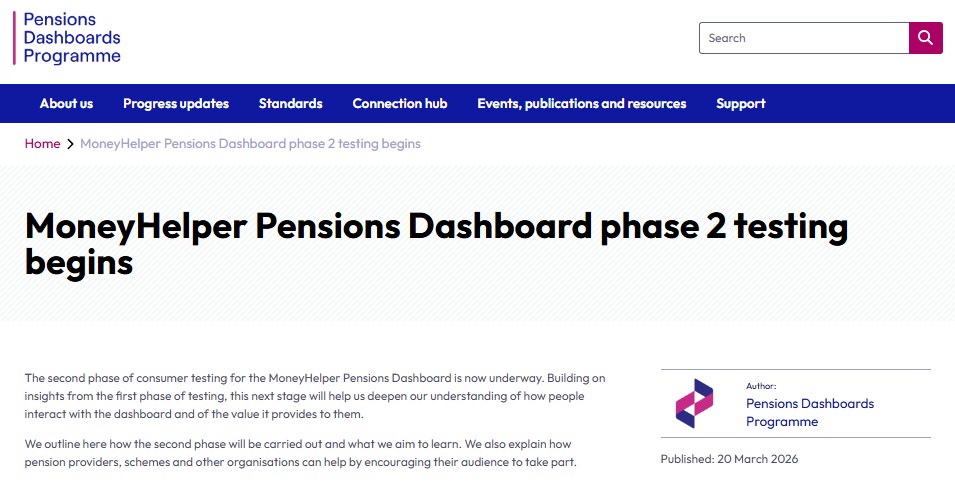

20 March 2026 – PDP blog and FCA speech
PDP publishes a blog article about Phase 2 of the live consumer testing of the MHPD.

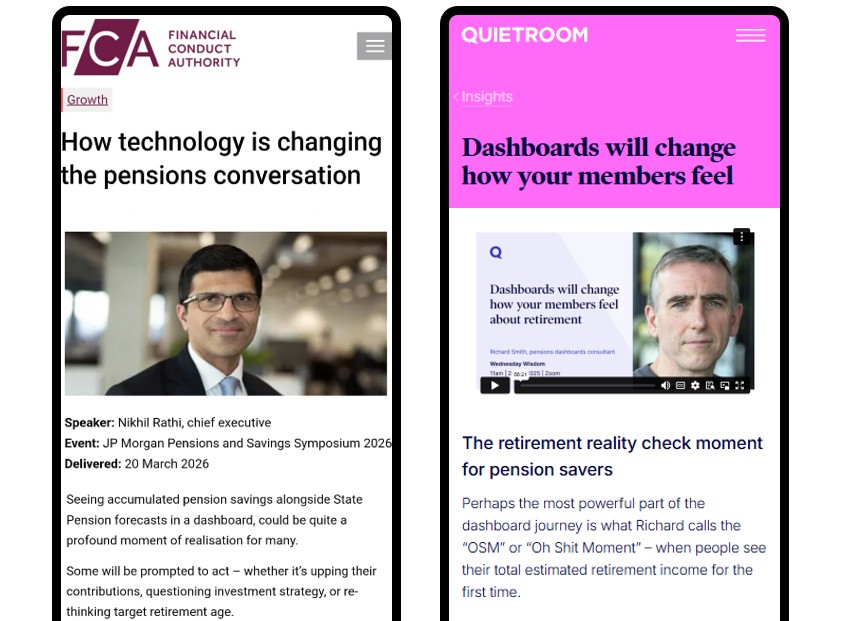

Meanwhile, in a speech from the FCA Chief Executive, Nikhil Rathi says “Seeing accumulated pension savings in a dashboard could be quite a profound moment of realisation for many” (echoing my comments a year ago, which I point out on LinkedIn).
In a separate speech at the same event, TPR Chief Executive Nausicaa Delfas says “Pensions dashboards will bring a huge focus from pensions savers”.

18 March 2026 – L&G / Public First research report
A Legal & General press release announces a new research report on under-saving, produced in collaboration with Public First and highlighting the huge opportunity for “dashboards [to] help people take stock of their pension prospects, and act where possible to help get them back on track”. I promote it in a LinkedIn Post.

17 March 2026 – SMF / Standard Life research report
A Social Market Foundation (SMF) media release announces a new research report, sponsored by the Standard Life Centre for the Future of Retirement, on the Pension Shock Gen X will feel when they release how small their pension incomes are going to be. The report mentions the MoneyHelper Pensions Dashboard (MHPD) throughout, so I promote it in a LinkedIn Post, and I even write a short poem about it – just for fun!

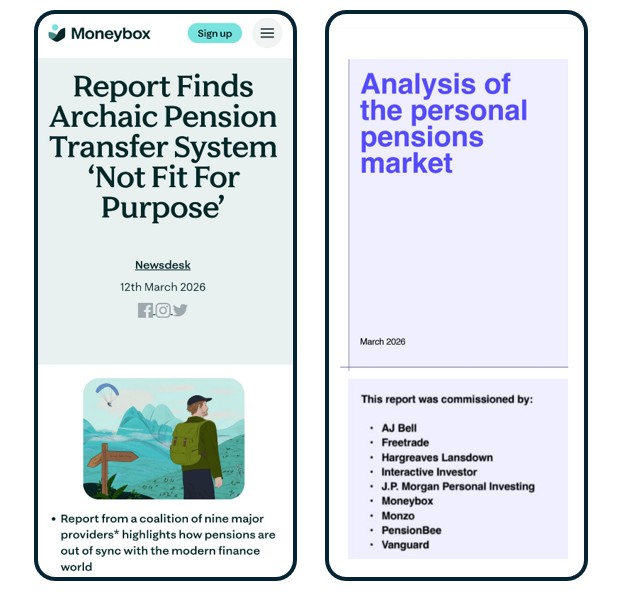

12 March 2026 – Pension market report
A major market analysis report from a coalition of nine pension providers states that “The current transfer experience is not adequate to take advantage of the opportunity which the Pensions Dashboard initiative represents”, and I promote the report in a Linked Post.

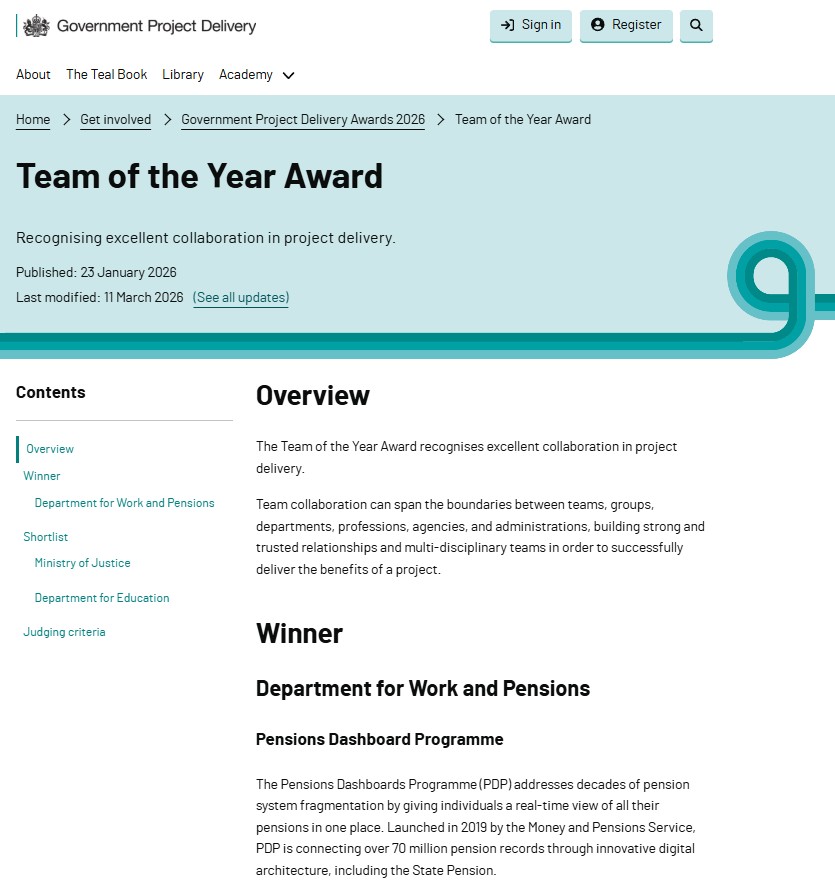

11 March 2026 – PDP project delivery award
In the Government Project Delivery Awards 2026, the MaPS PDP team wins the “Team of the Year Award” for their “transformative reset, following a 2023 red rating, dismantling silos and creating an inclusive, learning-focused culture … now holding amber status with high ministerial confidence”.

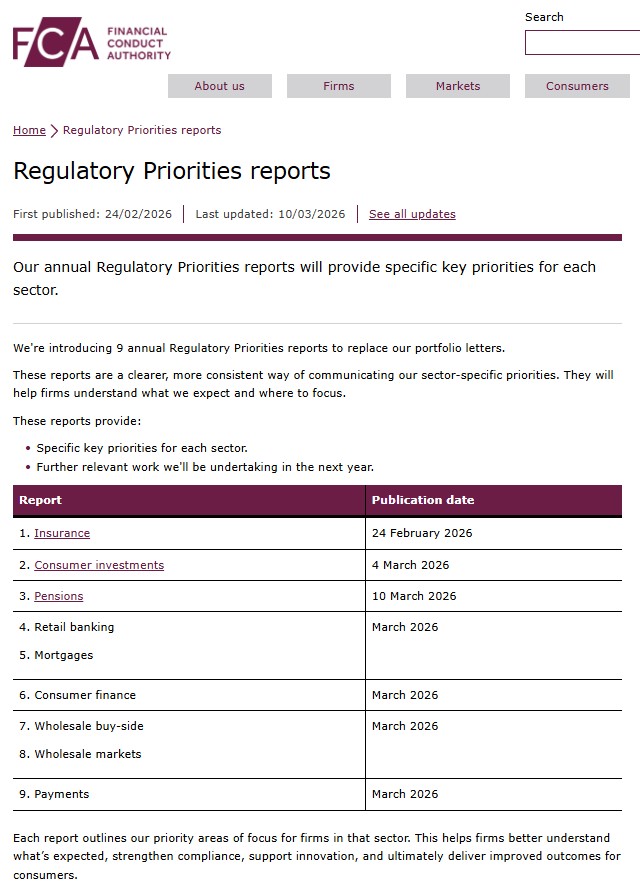

10 March 2026 – FCA Regulatory Priorities
FCA publishes its new Regulatory Priorities report on pensions, saying one of the things “we’ll do this year” is “Continue work with the PDP and DWP on the introduction of private sector pensions dashboards”.

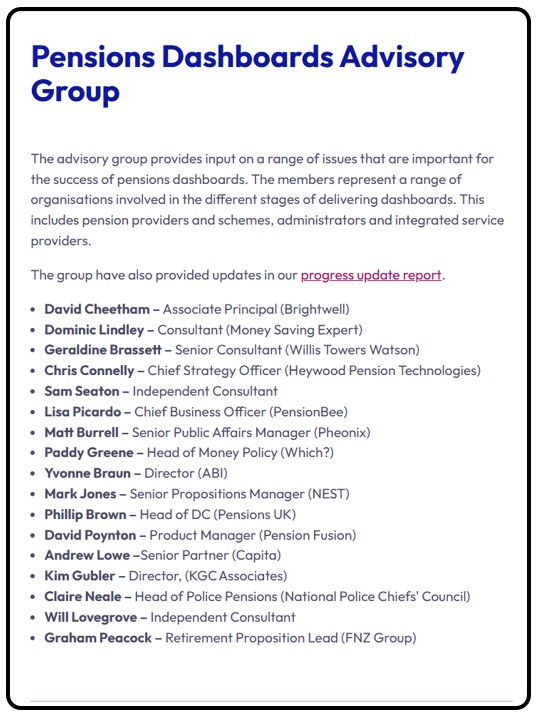

9 March 2026 – Updated PDP DCO & PDAG lists
On its “Who we work with” webpage, PDP provides updated lists of the members of the Pensions Dashboards Advisory Group (PDAG) and PDP’s Directly Connected Organisations (DCOs).

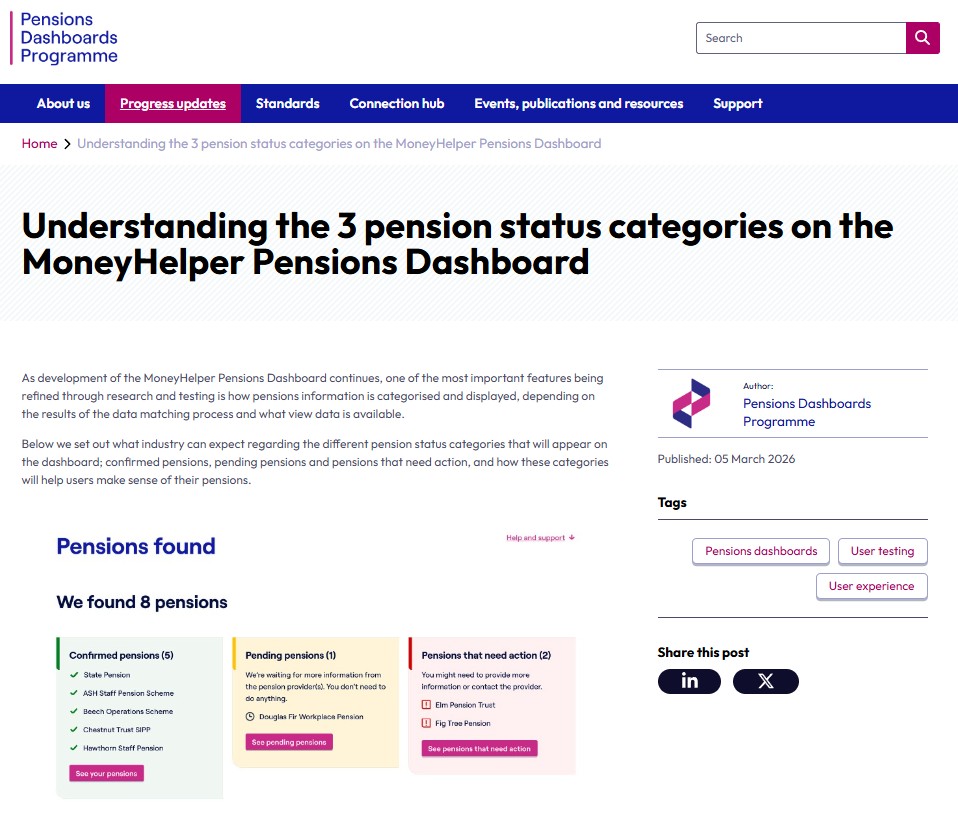

5 March 2026 – MHPD RAG pensions display
A PDP blog article explains what the red / amber / green categorisation of pensions means on the MHPD.

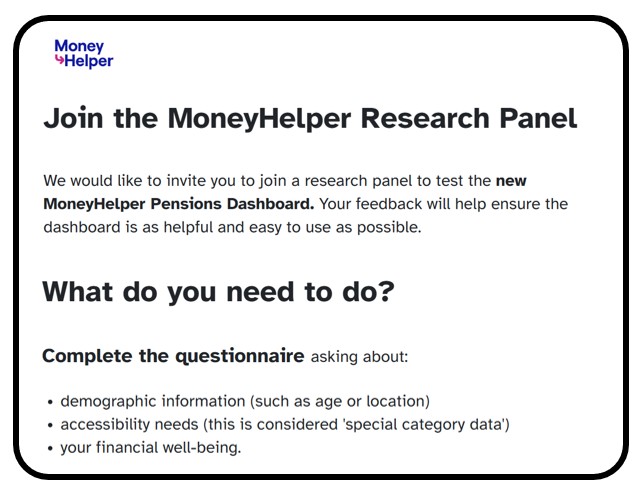

2 March 2026 – MHPD Phase 2 testing starts
Large scale, unmoderated, live consumer testing of the MoneyHelper Pensions Dashboard (MHPD), known as “Phase 2 testing”, commences with a PDP blog on the recruitment of consumer testers, which I subsequently promote in a LinkedIn Post.

25 February 2026 – Standard Life research report
The Standard Life Centre for the Future of Retirement publishes a research report, produced in conjunction with the Institute for Employment Studies, finding strong employer support for pensions dashboards (as I posted on LinkedIn).

18 February 2026 – MHPD accessibility
A blog article by MaPS’s Adam Gifford explains what is being done to ensure the MHPD is usable by consumers with a range of access needs and low digital skills, such as impaired vision, motor difficulties, cognitive or learning disabilities, and deafness or impaired hearing.

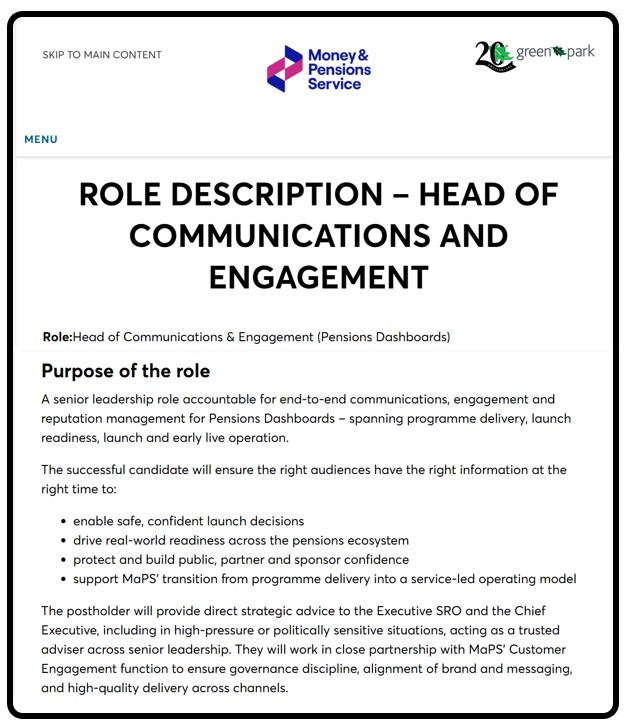

17 February 2026 – Head of Communications role
MaPS advertises for a Head of Communications and Engagement for the MoneyHelper Pensions Dashboard, looking to develop “a trusted communications plan underpinning launch decisions” over 12-18 months. With interviews in May, and the successful applicant in post by July (or September if they’re on 3 months’ notice), this suggests a potential 2028 MHPD launch.

10 February 2026 – Impacts for members
The management team of the UK’s biggest pension scheme (by assets) – the Universities Superannuation Scheme (USS) – holds a workshop, with me presenting, thinking about the question:
“What will the dashboard mean for our members?”
Lots of scheme- and employer-specific issues for consideration, making me think that every scheme in the country needs to have this debate – see my LinkedIn post about it.

7 February 2026 – MHPD job role
MaPS publishes an advert recruiting for a job (closing date 9 March 2026) which is the “central role in developing and enhancing the MHPD – a nationally significant service that truly matters”.
3 February 2026 – PASA webinar Q&A
Following its webinar in September 2025, introducing updated matching guidance and the dashboards toolkit, PASA publishes a written Q&A document.
28 January 2026 – PDP reporting standards
In a blog article, PDP announces the publication of a consultation on the updated draft version 2.1 reporting standards, closing on 25 March 2026.
27 January 2026 – SMF health check report
The Social Market Foundation (SMF) publishes a research report recommending MaPS offer consumers a pensions dashboard health check, after the consumer has seen their monthly total Estimated Retirement Income (ERI) on the MHPD. See Next Steps on my ERICA page for the link, or see my LinkedIn Post promoting the SMF’s report.
22 January 2026 – PDP data preparation blog
PDP publishes a new summary blog for smaller pension schemes and providers on what they need to do to prepare their data for connection to the dashboards ecosystem

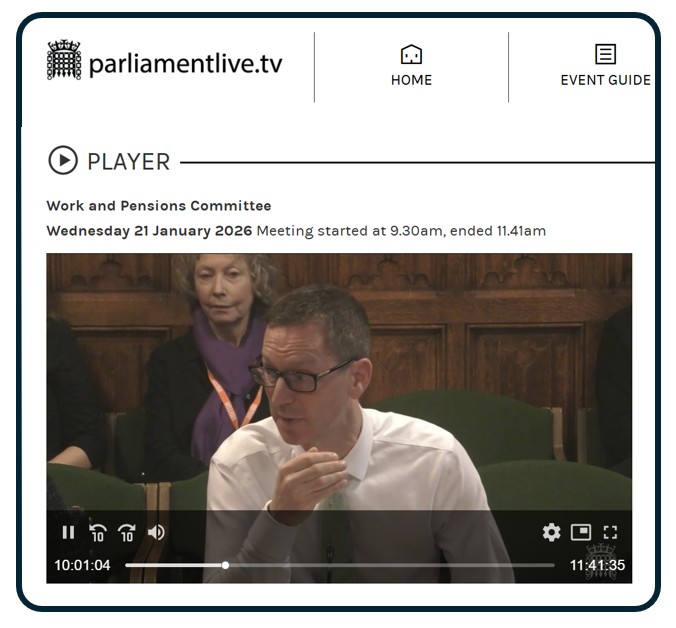

21 January 2026 – WPC oral evidence session
Speaking at an Oral evidence session of the Work and Pensions Committee, responding to a WASPI question from Corby and East Northamptonshire MP Lee Barron, Sir Peter Schofield, Permanent Secretary at the Department for Work and Pensions (DWP) says:
“The pensions dashboard, I think, is going to make a massive difference, enabling people to see not just their State Pension, but all their potential other pots available – [we are] working really hard to make a difference.”
At 11:26:15, Paisley and Renfrewshire South MP Johanna Baxter asks when the MHPD will be publicly available and Sir Peter says “at least six months away”.

8 January 2026 – PDP survey on a PSD VP group
PDP launches a survey (closing date in just over four weeks on Tuesday 10 February 2026) on how best to establish a Volunteer Participant (VP) group for potential operators of Private Sector Dashboards (PSDs).

7 January 2026 – PDP webinar Q&A
PDP publishes written answers to the 40 questions asked at their Progress Update Webinar held on Wednesday 10 December 2025.

1 January 2026 – Consumer live testing and data connections continue
As 2026 gets underway, live consumer testing of the MoneyHelper Pensions Dashboard (MHPD) continues. In July 2025, MaPS published its MHPD Consumer Testing approach and target timeline (on page 13).
If the testing goes well, we might get the Ministerial 6-month notice of the MHPD public launch by Christmas 2026, leading to a public launch some time during H1 2027 (see second timeline below). But it all depends on how well the testing goes – so keep abreast of updates.
Meanwhile all remaining in scope pensions data which is not yet connected to the dashboards ecosystem is due to be connected over the next nine months (Jan to Sep 2026) – see the Part 2 staging timeline below.
